Question

Unit Rate in Project Revenue Budget

  • January 14, 2026
  • 1 reply
  • 36 views

kristianharianja
Semi-Pro I
Forum|alt.badge.img+3

It looks like when putting up revenue budget in Project, the Unit Rate doesn’t populate price that is effective on the start date of the project.

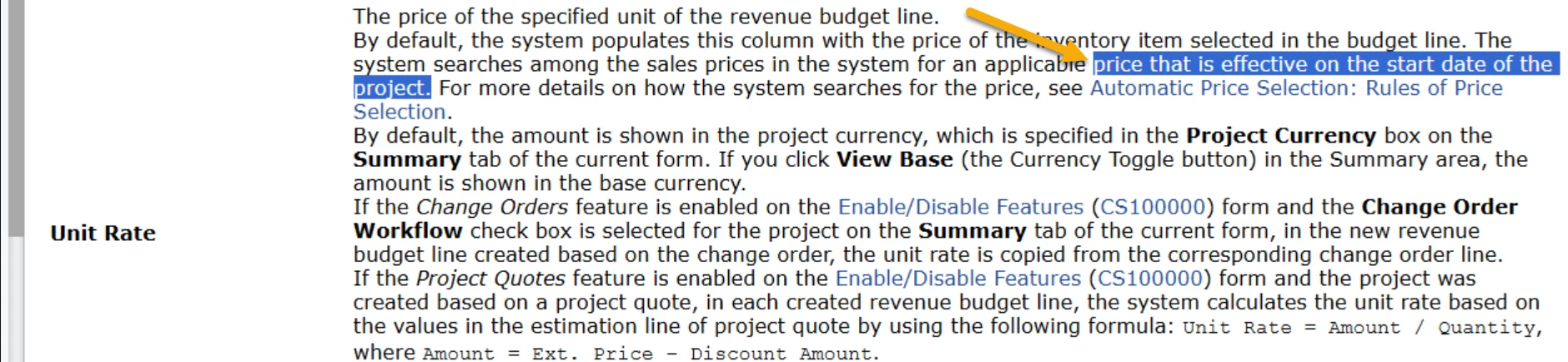

Wiki below suggests that the rate should use the effective rate but it doesn’t appear so.



Example:

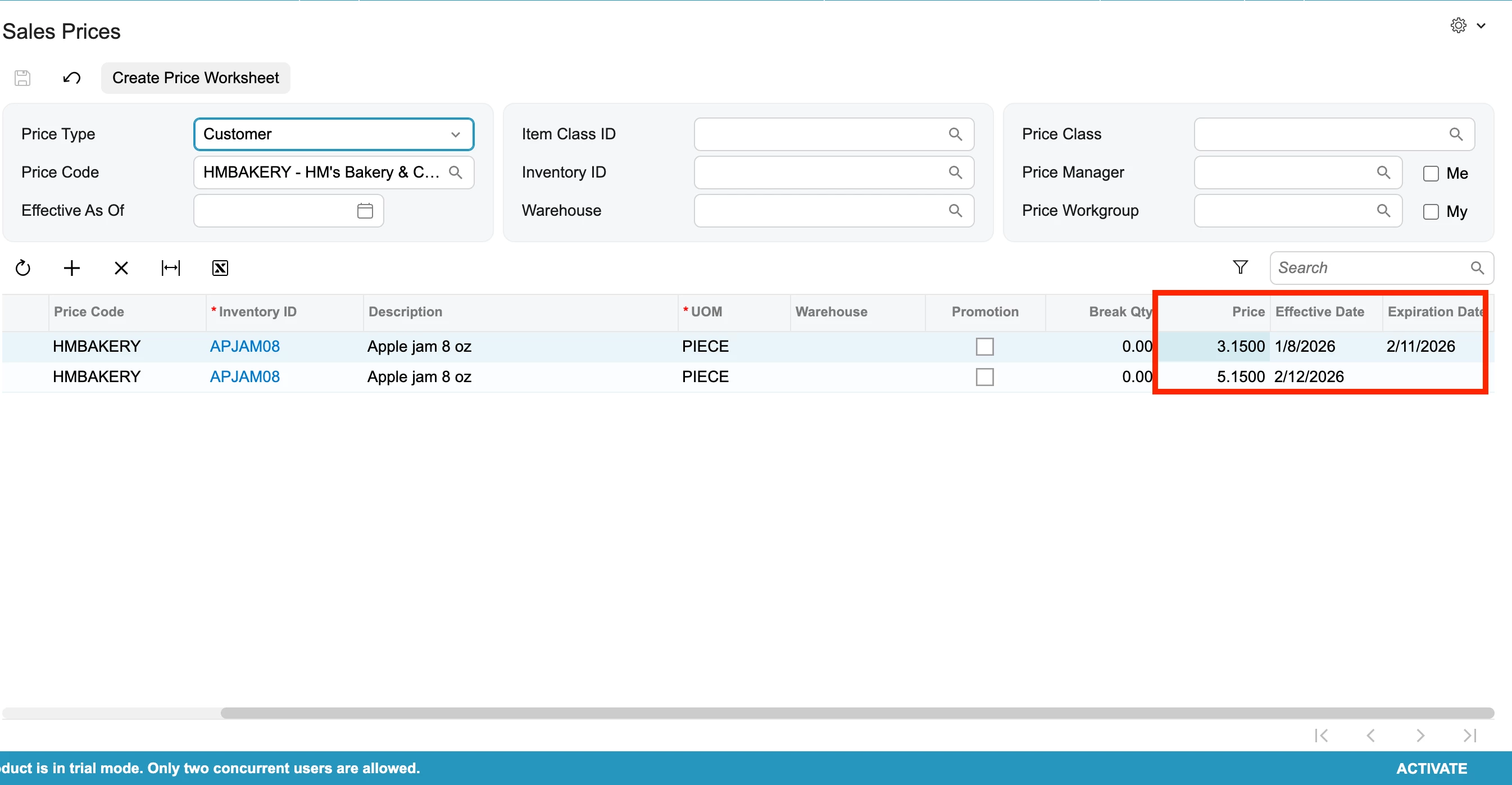

Price is setup on an inventory ID for a customer price class:

Item 111 for customer price class AAA: $105 expired at 14-Dec-2025.
Item 111 for customer price class AAA: $110 effective from 15-Dec-2025.
All other info such as UOM, currency, etc are equal.

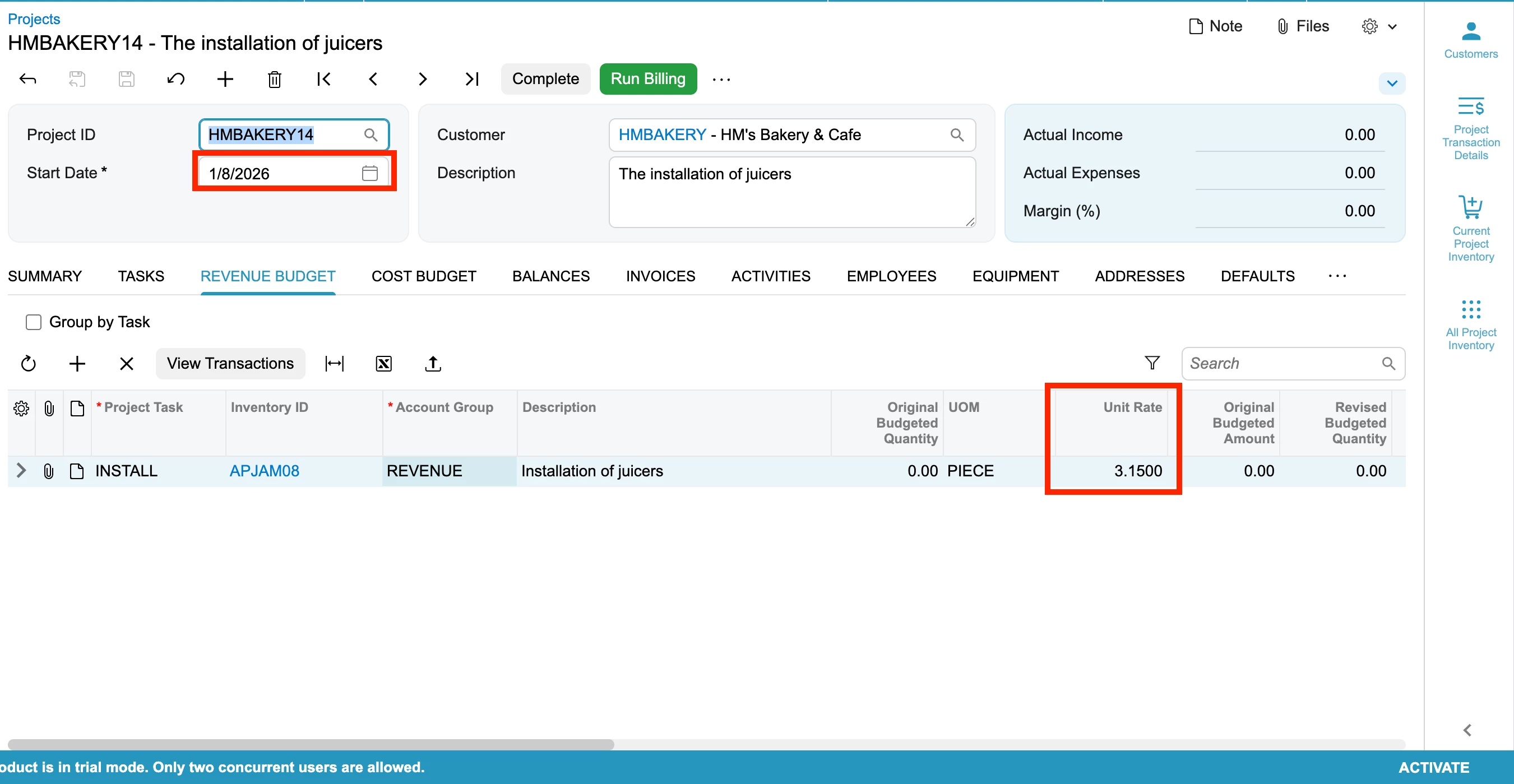

But when setting up revenue budget of a project that starts from 16-Dec-2025 for customer that belongs to the above price class, the populated Unit Rate is $105.

Anyone has same issue? and if so, how do we solve this?

1 reply

Forum|alt.badge.img+1

hey ​@kristianharianja , Yes, as per the documentation, it says that Acumatica will pick up the price of the item if the Project Start Date = Sales Price Effective Date.

So if my Project Start Date is of 16-Dec-2025, Acumatica will search for the same item, under Customer price class, if it has a pricing defined on the same effective date, i.e. 16-Dec-2025. It wont look up if the pricing is defined on any other dates. It should be equal Project Start Date.
Else it will pick up the default price.





It doesnt take into account the Business Date.


Hope this Helps!!
