Skip to main content
Solved

Adding signature line for architect to Change Order (PM643000)

  • Jul 14, 2023 11:47 PM UTC
  • 9 replies
  • 173 views
  • Translate All

Forum|alt.badge.img

Our company would like the Printed Change Order report (PM643000) to include the architect contact information and signature line like it exists for the contractor and owner. I understand how to add the signature line and the conditional statements for contact information but I’m not sure how to access the actual data for the architect contact data.



I’m not seeing where architect is defined at the Change Request or Change Order form. Does the Architect have to be added to the Project as a contact and if so would I be able to use the contact values in the report?

Am I thinking about this wrong and this should somehow be tied into approvals? Any advice is welcome.

Best answer by jsieber

@Chris Hackett yes, I was able to work through setting up the correct relations to access the data with the PMProject, Project Contact, Customer, Contact, and Address tables.

View original

9 replies

Laura03
Captain II
Forum|alt.badge.img+20
  • Captain II
  • Jul 15, 2023 12:22 PM UTC

Hello @jsieber ,

It seems to me that your thinking is normal. 😀

First we Report Designers need to figure out where the Data is seen on the screens.  Out of the box, Projects do not have an ‘Architect’ field.  Ask the users to show you where they are recording the name or employee id of the Architect on each project.  It’s possible the Architect has been added as a Project Attribute.

As an Example, I added Architect in Configuration → Attributes screen.

I connected my new Attribute to Projects module in Project Attributes screen.

Now we can add the Architect’s name on the Attributes tab of every Project:

Project Attribute: Architect

Once you can see where the architect name is being recorded, use Customization → Inspect Element to determine the field name, in what table/DAC it’s being stored.

If new Attributes were added to hold the architect names, then Refresh All tables in the report so you will be able to see the new attribute fields and add them to your report.



Translate

Forum|alt.badge.img
  • Author
  • Jr Varsity III
  • Jul 17, 2023 10:45 PM UTC

@Laura02 Thanks! This is getting me closer. Instead of adding an attribute at the project level I was attempting to use the contacts grid and then define the Contact Role as Architect. I’m still a little confused as to how I can directly reference the contact record for the project when the “Role” is equal to “Architect”. Would this approach work and do you have any guidance you can provide. Thanks in advance!

Translate

Laura03
Captain II
Forum|alt.badge.img+20
  • Captain II
  • Jul 18, 2023 12:18 AM UTC

Hello @jsieber ,

Can you show a screen shot of the Contacts grid/Contact Role mentioned above?  Neither my Projects screen nor my Change Orders screen has a place to store Contacts.

Looking again at Projects screen, I noticed an Employees tab.  If you are not already using Employees tab to restrict Employees, and if the Architect is one of your employees, using Employees tab might be an easy way to connect the correct employee’s contact information to each project, for printing their architect contact data with the signature line on the Change Orders.



Translate

Forum|alt.badge.img
  • Author
  • Jr Varsity III
  • Jul 18, 2023 1:45 AM UTC

Hi Laura,

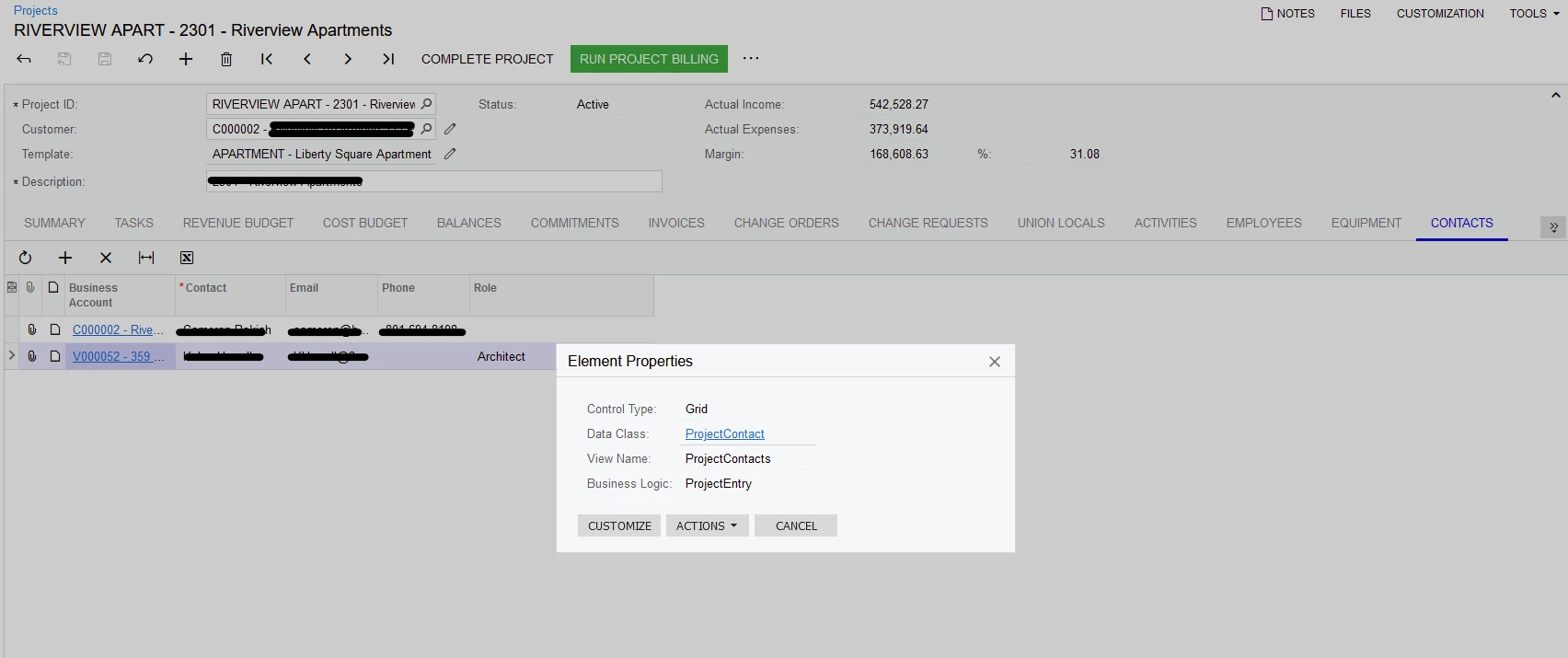

Here is my contacts tab/grid which is located at the Project level. The architect is a vendor, so they are entered as such and not an actual employee. Thanks again for your advice!



Translate

Forum|alt.badge.img
  • Author
  • Jr Varsity III
  • Jul 22, 2023 12:13 AM UTC

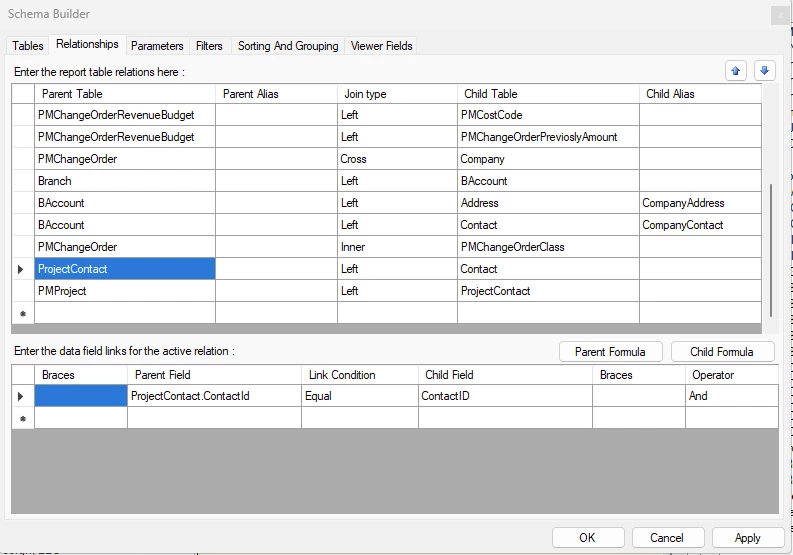

@Laura02 Sorry, I forgot to tag you when I posted the screen shot of the project contacts. I see that project contacts are stored in the ProjectContact table. I created a Relationship between ProjectContact and Contact using the link condition below.

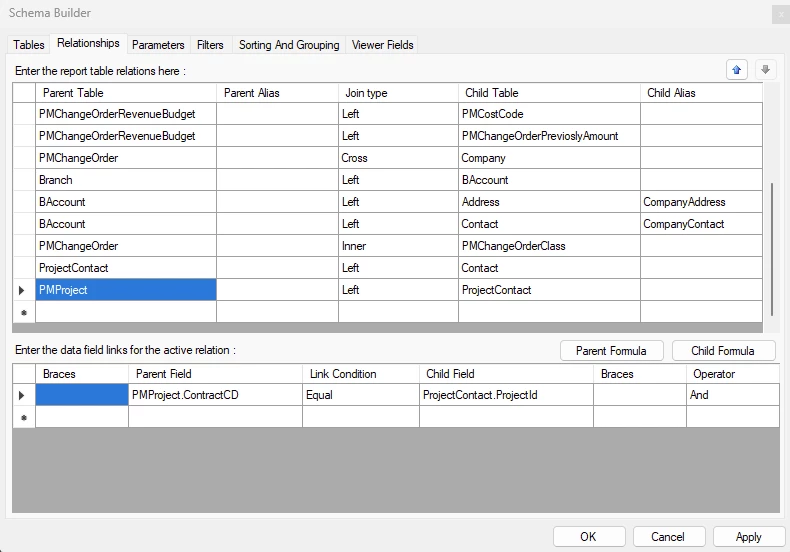

I also created a relationship between PMProject and ProjectContact using this link.

After applying this, I get an error when previewing the report before even trying to add data, so I know I’m not doing this correctly. My hope once I have the relationships and linking correct I can then use an expression to only show a contact with the role value of architect.

Translate

iqraharrison
Captain II
Forum|alt.badge.img+9

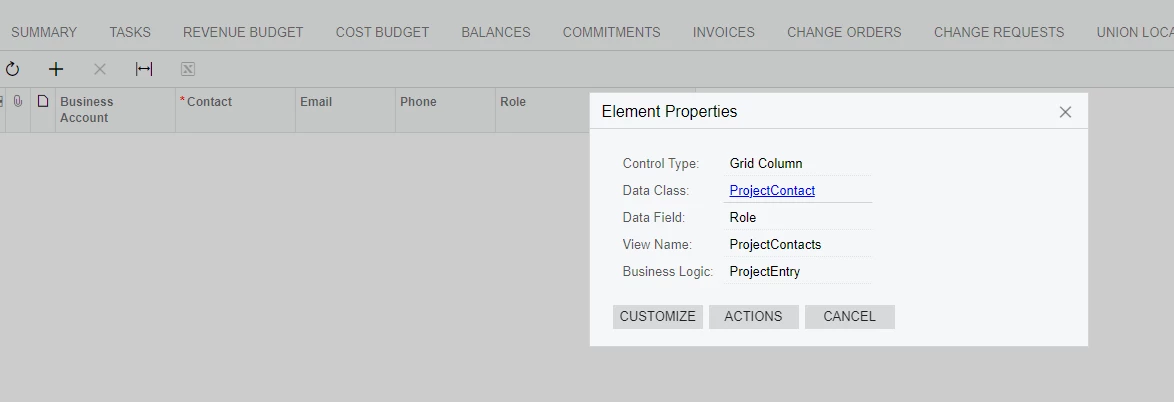

@jsieber can you change the contact to role? when i inspected the element for the role column, i found this:



Translate

Chris Hackett
Community Manager
Forum|alt.badge.img
  • Acumatica Community Manager
  • Aug 10, 2023 9:06 PM UTC

Hi @jsieber were you able to find a solution? Thank you!

Translate

Forum|alt.badge.img
  • Author
  • Jr Varsity III
  • Answer
  • Aug 12, 2023 3:55 AM UTC

@Chris Hackett yes, I was able to work through setting up the correct relations to access the data with the PMProject, Project Contact, Customer, Contact, and Address tables.

Translate

Chris Hackett
Community Manager
Forum|alt.badge.img
  • Acumatica Community Manager
  • Aug 12, 2023 6:02 AM UTC

Thank you for sharing your solution with the community @jsieber!

Translate
